Driven by the speed of HPC adoption and the pace of technological advancements, traditional datacentres are struggling to cope with AI's intensive power and cooling requirements, not to mention the time it takes to build a traditional datacentre and the inflexible approach to scaling.
The solution to this problem is a modular datacentre, or MDC. An MDC is a prefabricated datacentre built in a fixed footprint (shipping container) or assembled on-site. It offers quick, flexible deployments, crucial for fast-evolving AI workloads. The prefabricated nature of MDCs can more efficiently manage build times, power density, and cost.

Turboscale started building out modular datacentres for crypto mining in 2020, and as crypto mining grew, so did our experience. Fast forward to today and Turboscale has built over 1GW of modular datacentres all over the world. From a datacentre in a box (or many boxes), to prefabricated components shipped to site and built in situ, we’ve got the experience to make your project a success.
We design and prefabricate to order, test and ship anywhere in the world within 6 months of ordering. This allows for rapid deployments and mitigates the risk of traditional datacetres being obsolete before the groundworks are even started.
At a fraction of the cost of a traditional datacentre, Turboscale MDCs help our customers to realise ROI quicker, hit sustainability goals and start to recognise revenue from day one with advanced finance options and a very low PUE.

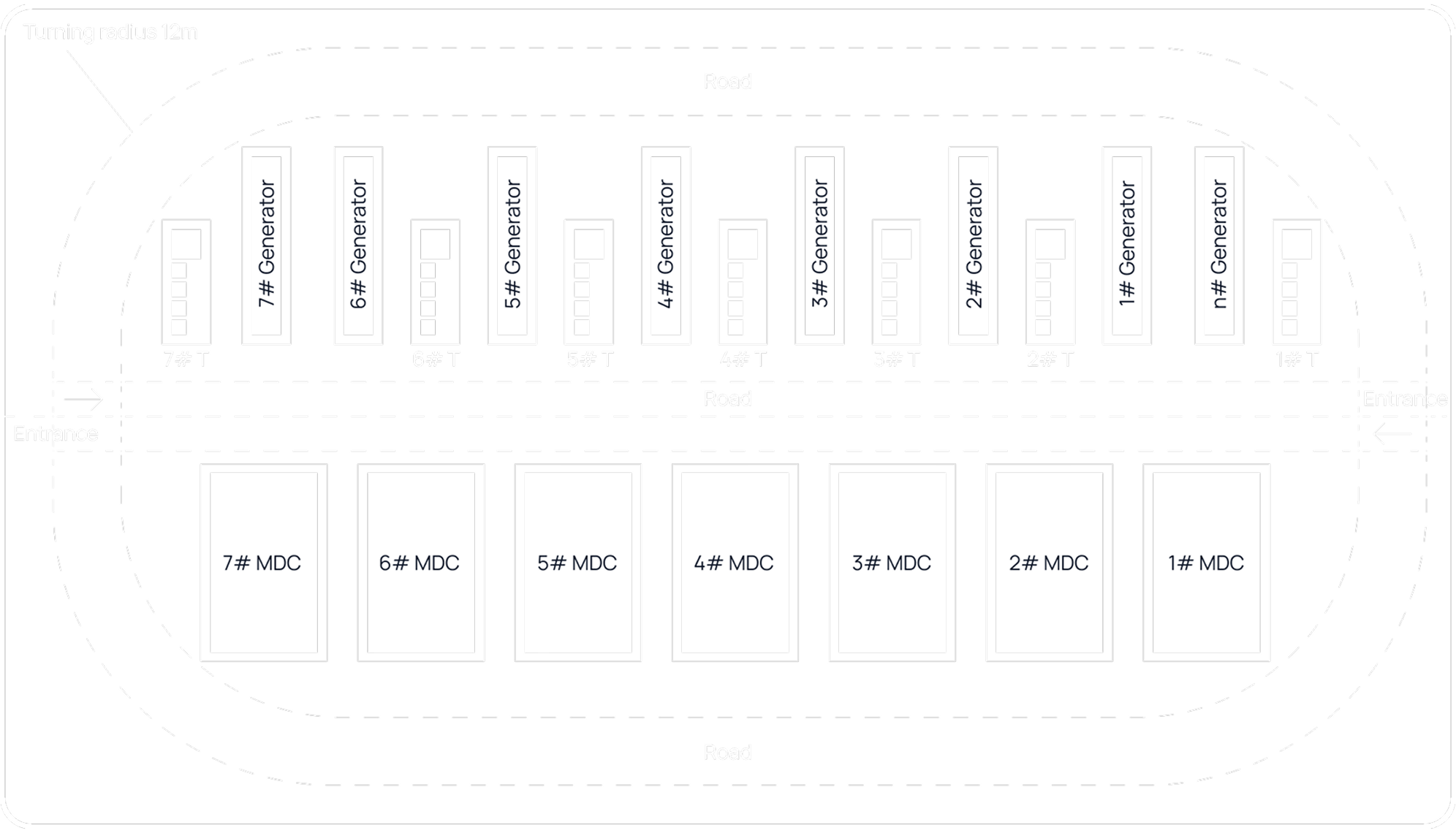

Any container size supported
In addition to the MDC, Turboscale can procure and install HPC hardware on-site and integrate it with your existing systems. To give you additional peace of mind, our support and management options incorporate as much or as little as you like.
If you need finance, don’t worry about that either. We’ve got an integrated finance solution to streamline the process for you. Whether you’re looking for a modular datacentre, HPC infrastructure, support, integration, financing or any combination of the above, Turboscale can cover it all. We make the complicated simple.

Week 1-4
Complete discovery phase
Finalize system architecture and drawings
Develop a construction schedule and budget
Week 5-8
Acquire infrastructure components
Customize and QA equipment prior to shipment
Week 9-13
Ship modular components to site
Weeks 14-18
Modify containers and perform on-site installation and wiring
Week 19-22
Test power, cooling, monitoring, and security systems
Weeks 23-24
Conduct client acceptance
Deliver documentation, training, and post-deployment support
